Click here for instructions on How to Print a Web Page
References: R Record keeping requirement | E An engineering/certification requirement | P A permit to work requirement | S A safe work method statement (SWMS) / written plan
Note: This section is to be read in conjunction with:
Informative
Plant & Equipment used in concrete pumping includes the following:
Hazards
Potential hazards include, but are not limited to:
Planning
Proximity hazards must be identified prior to set-up and assembly including:
Where planning to use concrete pumps, consideration must be given to site logistics and public safety, including:

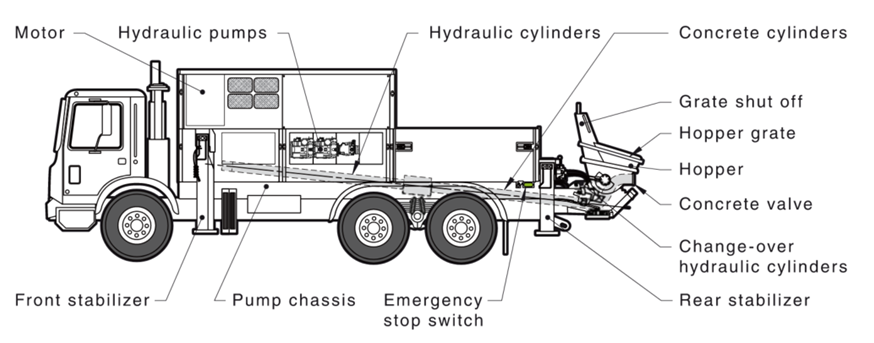

Planning – Line Pumps / Mobile Placing Boom
E
Ground bearing pressure for intended loads from truck / outriggers (including setup on suspended slabs) and suitability of set-up location must be confirmed prior to set-up and be in accordance with engineer’s report / specifications and where required any authority approval/ requirement,

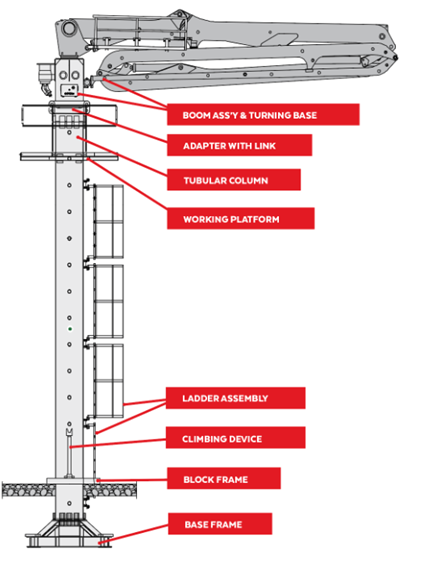

Planning – Satellite Placing Boom
E
A satellite placing boom design and staging must be completed by a Qualified Person.
E A Competent Person must supervise the assembly and installation of a satellite placing boom, verify the assembly is in accordance with the manufacturers specifications and provide handover documentation.
Operational
S A task-specific SWMS is required for concrete pumping activities; SWMS’s must be submitted to MPX for review prior to concrete pumping activities commencing on site.
R People carrying out concrete pumping work must be inducted into applicable SWMS and hold valid records of competency / training, evidence must be retained on site, refer to:

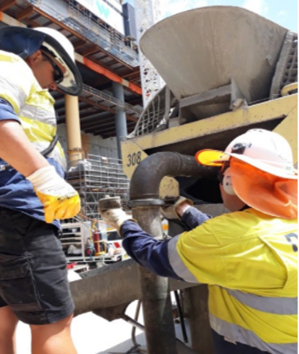

Concrete delivery trucks should have clear and safe access to / egress approach from the concrete pump hopper.
Traffic controllers / spotters and any truck driver discharging at the pump should be in positions which prevent them from being caught between the hopper and a reversing truck (e.g., out of “line of fire”).
R Concrete line pumps and concrete placing booms (mobile and satellite) must be inspected and maintained as per the manufacturer’s specifications and applicable regulatory requirements– refer to:
R Concrete pumps and concrete placing booms (mobile and satellite) must be inspected and registered on site prior to use on site and in accordance with MPX Procedures - refer to
Pipes and Clamps
R
Concrete pipe thickness testing (incl. bends and reducers) for line pumps, mobile placing boom and satellite placing booms must be conducted at frequencies in accordance with AS 1418.15 Cranes, Hoists and Winches – Concrete Placing Equipment. Refer to

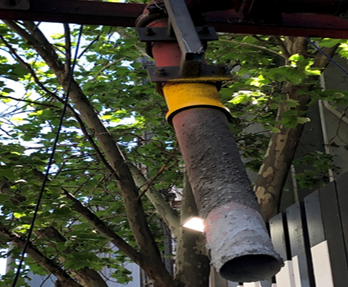

Pipe clamps used on any pipeline system must be:
Quick release clamps must be fitted with locking pins (R-Clips) to prevent inadvertent release.
Pipe clamps that have worn pins, cracks, deformations or any other signs of excessive wear must not be used.
Individual components of a pipeline system must be compatible and comply with the pump manufacturer’s specifications.
A pipeline must be installed as per AS 2550.15, verifying that:
Note: Cranes or hoist towers, scaffolding or formwork should not be used to support/secure the pipeline unless specifically designed for purpose of supporting concrete distribution pipelines, where used support must be installed in accordance with the design.
Cleaning out / Blowing Out concrete pumping equipment and trucks
Cleaning out concrete from pumping equipment (e.g., pumps, pipelines etc.) must only be carried out by Competent Persons and in accordance with the manufacturer’s procedures or suppliers/subcontractors SWMS
Where practicable concrete trucks should be taken back to the off-site batching plants to be cleaned out.
Where concrete trucks or concrete pumping equipment is required to be cleaned on site, cleaning out must be in designated areas, concrete must be collected / retained in bins or plastic lined trenches or similar and not be washed out onto open ground / stormwater drains, etc.

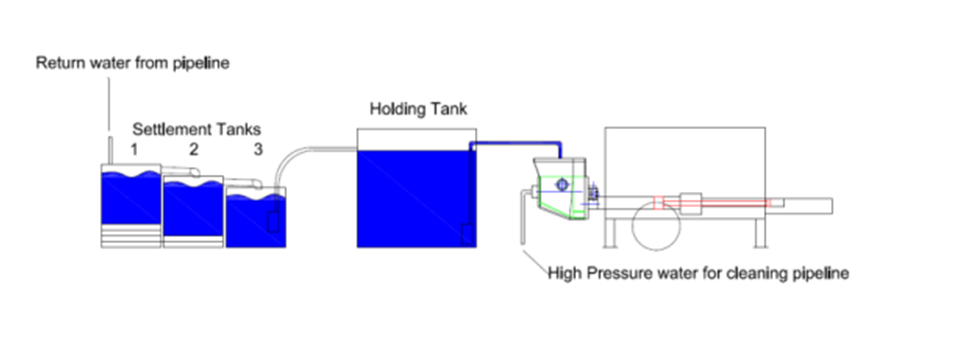

Where cleaning of static concrete pipelines is undertaken using water:
S Task specific SWMS or SOP is required
Where cleaning of static concrete pipelines is undertaken using compressed air into a concrete waste bin or a concrete truck agitator:
S Task specific SWMS or SOP is required

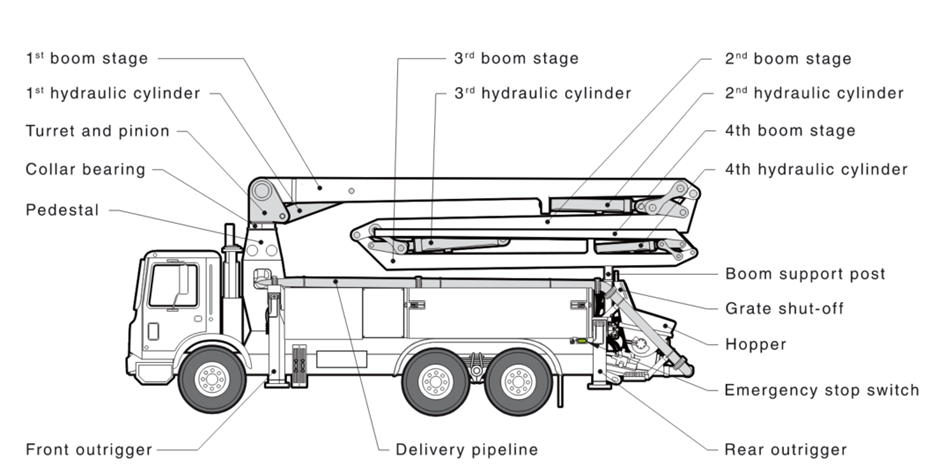

Operational - Mobile Placing Boom
P Prior to setting up a mobile placing boom the following must be implemented:
Concrete pumps should not be operated unless the opening of the hopper is fitted with a safety grille / guard:
Mobile placing booms must not be left unattended while in operation
Exclusion zones (e.g., barricading and signage), protective screens, or barriers must be established around the mobile placing booms and concrete line.
Grilles must:
Workers are not permitted to stand on the grille
Operational – Satellite Placing Boom
R NSW - Where climbed / sections are added, and a handover certificate must be provided to MPX prior to use.
R All electrical connection points/sockets including the head control box (located on the crow’s nest) of the satellite placing boom must be inspected, tested and tagged as a minimum every 3 months.
Concrete - Kibbles
Legal and Other Requirements
Document Control
Version 1 August 2019 – New Standard
Version 2 July 2022 – Inclusion of the requirements for
